How Manufacturers Plan a Multi-Plant Workforce Development Platform Rollout

10 min read

Manufacturing operations director in an orange hi-vis vest carrying a hard hat, beside a grayscale photograph of a plant floor

Key Takeaways

  • The rollout that fails is not the one nobody uses. It is the one every plant uses differently.
  • Fragmentation happens after go-live, when plants adapt the platform to local habits.
  • The rollout succeeds or fails on 4 upfront decisions about what HQ standardizes and what plants configure.
  • Pilot at the hard plant, not the easy one. The easy plant tells you nothing about what will happen at plant 4.
  • Governance matters more than launch. Adoption is a moment. Standardization is a discipline.

Multi-plant manufacturers spend a year planning a workforce platform rollout, another year deploying it, and a third year discovering that every plant is using it differently. The training is happening. The completions are logging. The compliance officer at HQ still cannot produce a single fleet view of who is current on what.

This is the pattern that repeats across almost every multi-plant rollout. The failure mode is not the loud one. It is the quiet one. The system goes live at every plant on the timeline the deployment plan promised. Then, month by month, each plant starts adapting the platform to how it already worked. Local workarounds re-emerge. Plant HR leads customize the assignment logic to match their shift patterns. The training taxonomy at plant 2 slowly diverges from plant 5. And 18 months after go-live, the enterprise view HQ was buying does not exist.

This article walks through why multi-plant rollouts fragment, the 4 decisions that determine whether the platform holds together, the phased sequence that holds up across a network, and how to build the governance that prevents post-adoption drift.

Why Multi-Plant Rollouts Fragment Instead of Fail

Multi-plant deployments face challenges single-site rollouts do not. Each plant operates with different equipment, regulatory exposure, operator culture, and digital maturity. Plan on a global template covering 70% to 80% of a deployment, with the remaining 20% to 30% reserved for site-specific factors. That reserve is where fragmentation lives.

The Plant That Already Had "Something That Works"

Every multi-plant manufacturer has one plant with a training program the plant HR lead is proud of. Custom spreadsheets, a homegrown checklist, a paper certification binder that has worked for 15 years. That plant treats the corporate rollout as a duplication of effort. The platform goes live. The old system stays live in the background. Two systems now hold the same records, and neither is complete.

The Plant That Customized Itself Into Isolation

The plant with a shift-heavy schedule needs assignment rules that respect crew rotations. The plant with a strong safety culture wants extra approval gates before recertification lapses. Each configuration is reasonable in isolation. Together, they mean HQ cannot pull a like-for-like report across plants because each plant is running the same platform against slightly different rules.

The Plant That Adopted Early and Never Re-Aligned

The pilot plant is often the most enthusiastic. It configured the system 6 months before the other plants, using assumptions that later got revised at HQ. When the standard changed, the pilot plant did not update. It kept running against the old assumptions and now sits outside the standard the rest of the network is on.

The 4 Decisions That Determine Whether the Rollout Holds Together

The rollout succeeds or fails on 4 upfront choices about ownership. Manufacturers who skip these decisions in the RFP end up litigating them plant by plant for years afterward.

4 Standardization Decisions and What Happens If You Get Them Wrong

Decision

The choice that holds up

What breaks if you get it wrong

Who owns the training taxonomy

HQ owns the standard taxonomy; plants add local aliases only

Every plant creates its own taxonomy; HQ cannot roll up a fleet view

Who owns certification and compliance data

Central schema, plants populate against it

Plants track recertifications in local spreadsheets; audit findings surface at the plant level, not HQ

Who owns the core content library

HQ owns safety, quality, and compliance content; plants add equipment-specific modules only

Plants stop using HQ content because it does not match their equipment, and coverage drifts

Who owns local configuration authority

Bounded within an HQ framework, not open-ended

Over-prescription kills adoption; open-ended plant discretion breaks coverage

The pattern in the wrong-column entries is the same. HQ tries to be flexible, plants take the flexibility as a mandate, and 12 months later HQ discovers the platform is 5 platforms wearing one logo.

The Rollout Sequence That Holds Up at Scale

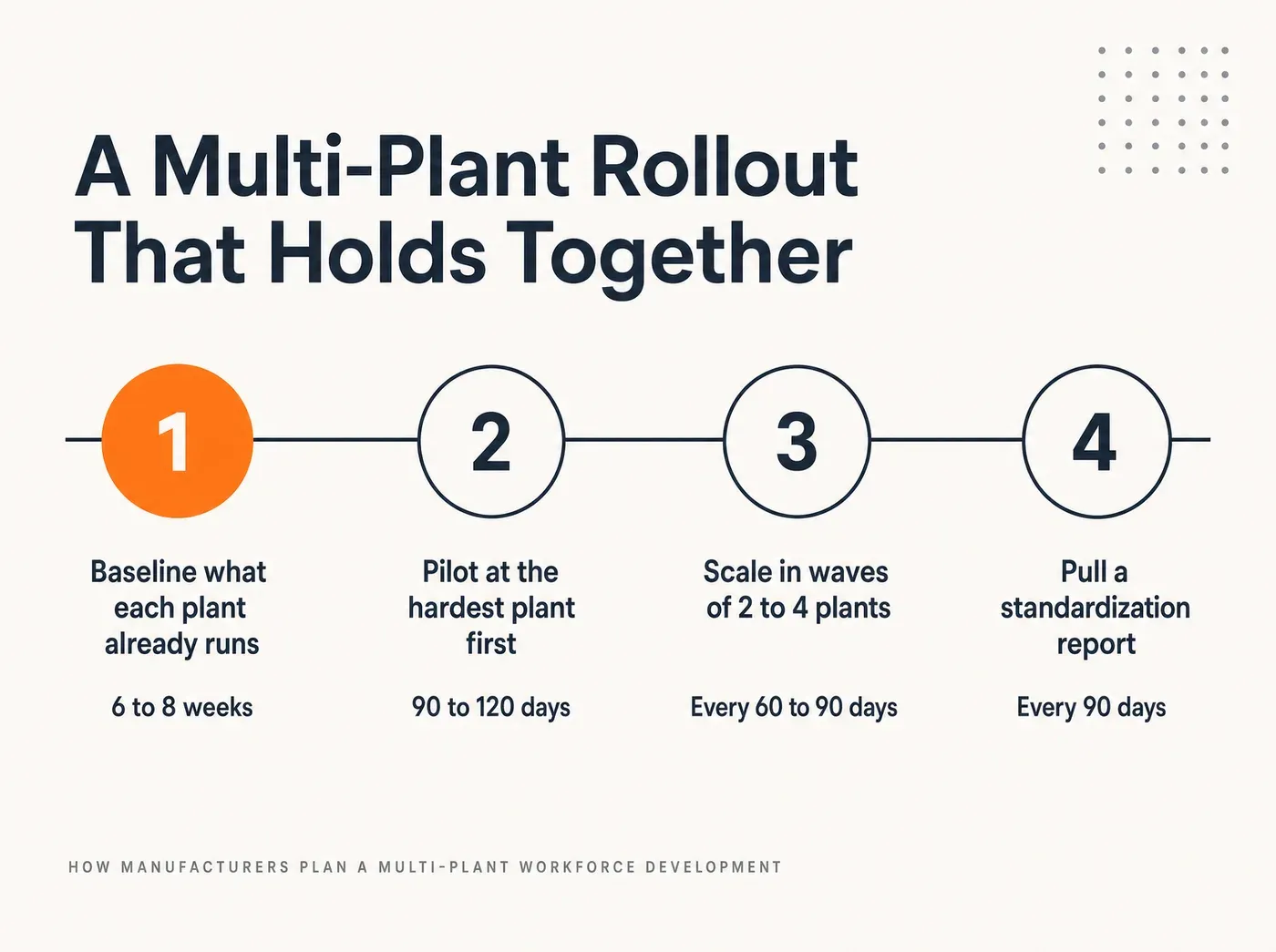

How Manufacturers Plan a Multi-Plant Workforce Development. A Multi-Plant Rollout That Holds Together Baseline what each plant already runs 6 to 8 weeks Pilot at the hardest plant first 90 to 120 days Scale in waves of 2 to 4 plants Every 60 to 90 days Pull a standardization report Every 90 days

Successful multi-plant deployments follow a wave pattern, not a big-bang launch. The sequence has 4 phases, each with a defined output the next phase inherits.

Phase 1: Baseline What Each Plant Already Runs

Before configuring anything, HQ documents what every plant runs today. The starting inventory covers the training programs each plant has, the certification cycles each plant tracks, the local systems each plant uses, and the percentage of the workforce each plant reports as compliant. Skipping the baseline means the rollout later collides with plant realities that were invisible during design.

Phase 2: Pilot at the Hard Plant, Not the Easy One

The pilot plant selection is the highest-leverage decision in the whole rollout. Most manufacturers pilot at the easiest plant, the one with strong HR leadership and an existing training culture. That plant will make the rollout look good. It will teach you almost nothing about the plants that will resist.

The pilot plant should have at least one hard variable the rest of the network also has. A union workforce, a legacy PLC-based operator training program, a shift schedule that breaks standard assignment rules, or a plant HR lead who is skeptical of HQ initiatives. What you learn at the hard pilot is what you use to design the scale phase. What you learn at the easy pilot is only useful at other easy plants.

Phase 3: Scale in Waves of 2 to 4 Plants

Full-network big-bang rollouts fail. Wave rollouts of 2 to 4 plants per wave, 60 to 90 days apart, let each wave inherit lessons from the last. The waves are grouped by variable, not geography. Union plants roll out together. Highly regulated plants roll out together. Automotive tier-1 plants roll out together. Each wave produces a set of configuration decisions that either fold back into the HQ standard or stay as documented plant-specific exceptions.

Phase 4: Governance to Prevent Post-Adoption Drift

Governance is where the rollout is won or lost. Every 90 days, HQ pulls a standardization report showing which plants have drifted from the standard, which local configurations are proposed for elevation to standard, and which local workarounds have re-emerged. Plants that drift receive a re-alignment intervention. Plants that surface useful local configurations get those elevated into the HQ standard. The platform stays coherent because governance keeps it coherent.

The Numbers That Say Why Multi-Plant Rollouts Now Matter More

Manufacturing has never been under more pressure to get workforce infrastructure right.

  • The 2024 Deloitte and Manufacturing Institute talent study projects 3.8 million new manufacturing jobs from 2024 through 2033, with roughly 1.9 million potentially unfilled if the skills gap does not close.
  • Demand for specialized skills such as simulation and simulation-software expertise jumped roughly 75% over the past 5 years, per the same Deloitte research.
  • Over 65% of manufacturers in the NAM Q1 2024 outlook named attracting and retaining talent as their primary business challenge.

Every one of those pressures shows up first at the plant level, and each requires a workforce record that HQ can act on. A fragmented rollout produces a fragmented record, and a fragmented record leaves HQ unable to answer basic workforce questions across the network.

How KnowledgeCity's Workforce Development Platform Handles a Multi-Plant Rollout

The most useful comparison for a workforce development platform in a multi-plant environment is not "with the platform" versus "without training." It is "with the platform" versus "fragmented tooling," because fragmented tooling is what most manufacturers currently run.

Fragmented Tooling vs. Standardized Platform Across the Rollout

Rollout stage

With fragmented tooling

With a standardized platform

Baseline

HR walks every plant manually and reconciles spreadsheets for months

HQ pulls current-state training coverage from the same HRIS-linked record every plant reports into

Pilot

The pilot plant configures its own instance the other plants will later have to conform to

The pilot plant uses the template plants at scale will inherit, with hard-plant variables surfaced early

Scale

Each wave discovers new configuration surprises; timeline slips

Each wave inherits configuration decisions from the last, with exceptions documented centrally

Sustain

Plants drift back to local spreadsheets and workarounds within 12 months

A quarterly standardization report flags plants moving off-standard before drift compounds

Audit

Compliance officer reconciles across plants for weeks

The audit view runs from one environment across every plant on the same schema

The platform that carries this pattern is KC LMS for role-based training assignment, completion tracking, and multi-plant analytics. KC Docs holds standard work and SOPs as version-controlled documents with acknowledgment tracking, so a change to the underlying policy triggers a re-acknowledgment at every plant. KC Skills produces the per-operator competency baseline that governance uses to detect drift before it shows up in an audit. All three read from the same worker record, so the plant view and the HQ view read from one source of truth rather than one per plant.

Roll Out Once. Standardize From Day One.

Frequently Asked Questions

1. What is a multi-plant workforce development platform rollout?

A multi-plant workforce development platform rollout is the coordinated deployment of a single training, certification, and competency platform across 2 or more manufacturing facilities. The goal is a shared taxonomy, shared content, and shared reporting across every plant, so HQ can produce a fleet view of who is trained on what.

2. How long does a multi-plant training platform rollout take?

A phased rollout across 5 to 15 plants typically runs 12 to 24 months. Baseline discovery takes 6 to 8 weeks. Pilot at 1 or 2 plants takes 90 to 120 days. Scale waves of 2 to 4 plants each run every 60 to 90 days. Governance starts before the last wave finishes and continues indefinitely.

3. Why do multi-plant LMS rollouts fail?

Multi-plant rollouts rarely fail from non-adoption. They fragment. Individual plants configure the system to match local habits, workarounds re-emerge after go-live, and the enterprise view HQ was buying erodes plant by plant. A global template usually covers only 70% to 80% of the deployment, with the remaining 20% to 30% reserved for site-specific factors, and that reserve is where fragmentation starts.

4. How should manufacturers pilot a workforce platform before scaling?

Pilot at the hard plant, not the easy plant. The hard plant is the one with variables the rest of the network also has: a union workforce, a shift-heavy schedule, legacy operator training, or a skeptical plant HR lead. What you learn at the hard pilot is what you use to design the scale phase.

5. How do manufacturers keep multi-plant training standardized after rollout?

Standardization is a governance discipline, not a one-time launch outcome. Every 90 days, HQ pulls a standardization report showing which plants have drifted from the standard, which local configurations should be elevated to the standard, and which workarounds have re-emerged. Drift interventions happen before the drift compounds into a fragmented enterprise record.

References

  1. Deloitte and The Manufacturing Institute. 2024 Talent Study: US Manufacturing Could Need 3.8 Million New Employees by 2033.
  2. Manufacturing Dive. Manufacturing Could Be Short 1.9M Workers if the Talent Gap Isn't Fixed.
  3. Code of Federal Regulations. 29 CFR Part 1904, Recording and Reporting Occupational Injuries and Illnesses.
  4. International Automotive Task Force. IATF 16949:2016 Automotive Quality Management Systems.
  5. International Organization for Standardization. ISO 45001:2018 Occupational Health and Safety Management Systems.
